Roads and bridges · Okobo LGAOngoing

Okopedi to East West Road

See the message that will be shared

I'm glad to share that work on Okopedi to East West Road in Okobo LGA is under way. Construction of the Okopedi to East West road in Okobo LGA.

See the photos and the facts here: https://umoeno.cavilconsult.com/projects/okobo-okopedi-to-east-west-road/

Does this road make your daily trip easier? Tell me in the comments, and share this with a neighbour so more people can see it.

Download project card

Construction of the Okopedi to East West road in Okobo LGA.

Key facts

Area of work
Roads and bridges
LGA
Okobo
Status
Ongoing
Flag-off
13 February 2024, by Governor Umo Eno, in Okobo LGA
Scope
Dualisation of 13.5km Okopedi - Oron road by East-West road (Phase II), with a bridge
Contractor
China Civil Engineering Construction Corporation (CCECC)
Contract value
N45 billion (February 2024)
Progress, July 2025
Over 56 percent overall; drains 75 percent, earthworks 67 percent, bridge piling under way; 24-month schedule
Ministry or agency
Ministry of Works & Fire Service
Contractor
China Civil Engineering Construction Corporation (CCECC)
History
Started by this administration
Started
13 February 2024

Photos

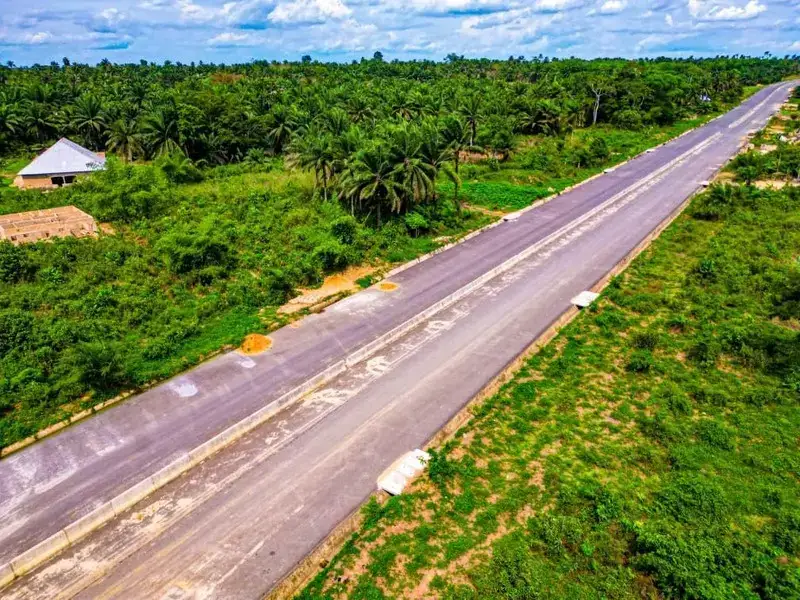

Okopedi to East West Road
Okopedi to East West Road

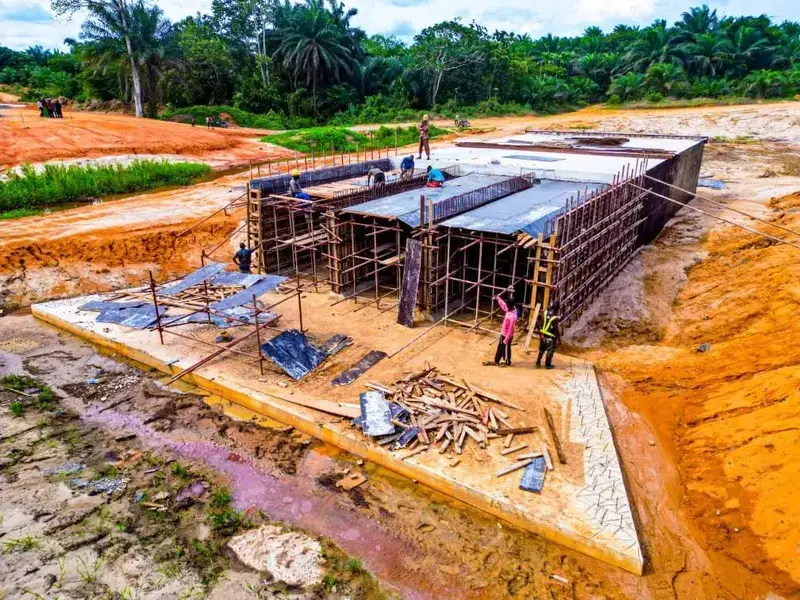

During workOkopedi to East West Road

About the project

This project is the dualisation of the 13.5-kilometre road from Okopedi in Okobo Local Government Area towards Oron and the East-West Road. It is Phase II of the dual carriageway that starts at the Airport and runs through Okopedi. The project includes a bridge.

The road is funded by the Akwa Ibom State Government and built by China Civil Engineering Construction Corporation (CCECC). The contract was valued at about N45 billion. Governor Pastor Umo Eno flagged it off on 13 February 2024.

By July 2025 the work was more than half done. Drains were about 75 percent complete, earthworks about 67 percent, and piling for the bridge was under way. The job was planned to take 24 months. No completion or commissioning date has been announced.

When finished, the road is expected to give Okobo and Oron a fast, safe dual carriageway to the Airport, Uyo and the East-West Road. It is meant to cut travel time and boost trade in the Oron area.

The project at a glance

StatusOngoing
Length13.5km
Kind of workRoads and bridges
ServesPeople of Okobo

Project timeline

Plannedannounced or approved
Work startedsite work begins
Ongoingwork under way
Finishedcompleted or commissioned
Work started13 February 2024

Okobo LGA at a glance

Where this project sits among all 10 projects recorded in Okobo.

10projects
Completed 2Ongoing 5 (this project)Planned 1Status not stated 1
Roads and bridges
5
Schools
2
Health
1
Government and public buildings
1
Homes for vulnerable people
1

Project location

Okopedi to East West Road

The map shows the area. An exact project pin is still being confirmed.

The map loads as you reach this section.

Development goals

This project supports the goals below. Each figure shows how many of the 429 projects on this portal back the same goal.

  • 9Industry and infrastructure200 of 429 projects
  • 11Sustainable communities133 of 429 projects

More from Okobo

See everything in Okobo

Governor Umo Eno speaking

Governor Umo Eno

See what is being done near you

Pick your LGA to see roads, schools, health centres and homes, with photographs.

Choose your LGA
